How Long Does It Take to Build a Luxury Home in Dripping Springs?

by Robbie English

longhorn road blog 1

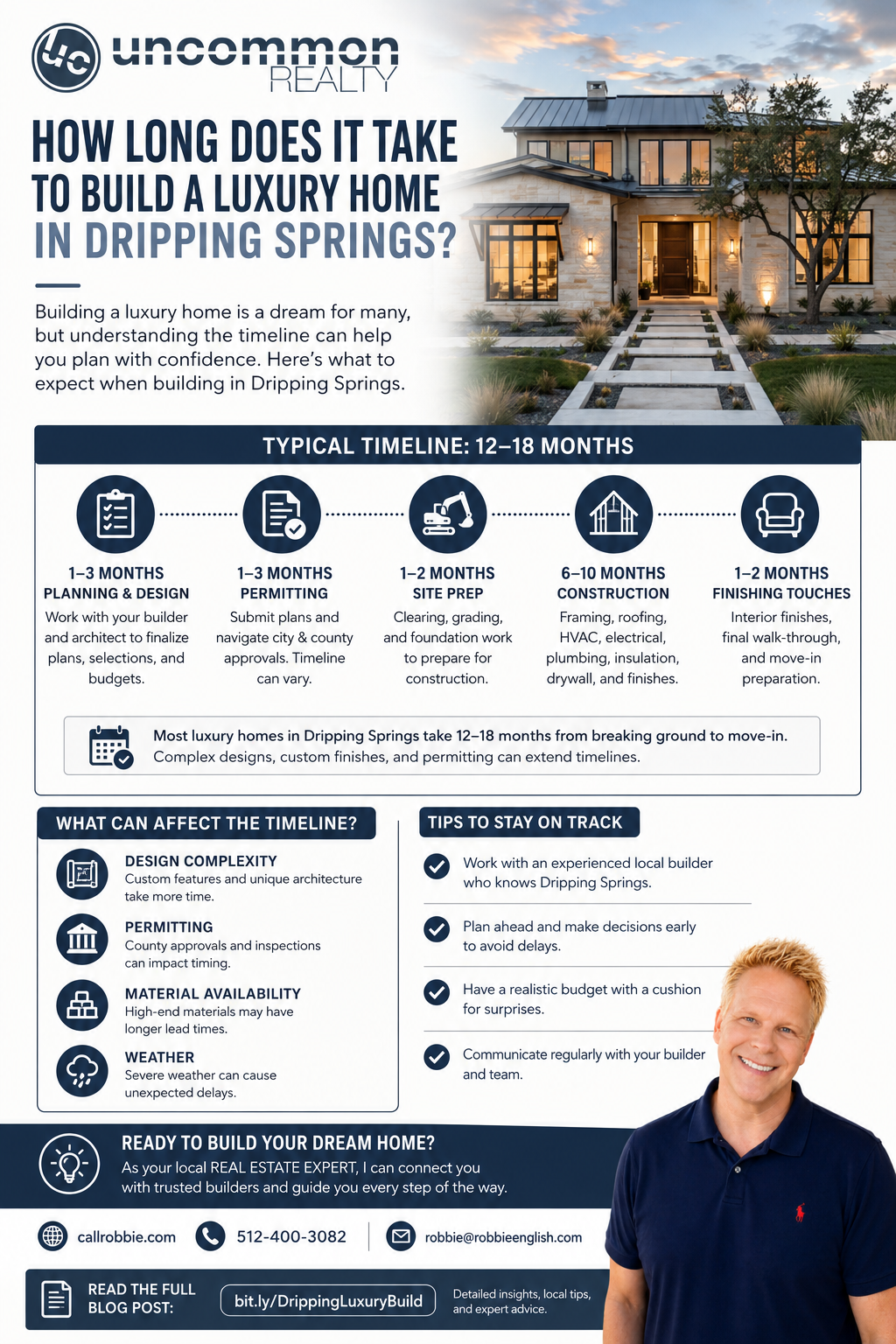

One of the first questions I hear from buyers considering a custom home in Dripping Springs is a simple one: how long does it actually take to build a luxury home out here? The honest answer is that a true custom luxury build in the Hill Country typically runs about 14 to 24 months from the day you start until you move in, and sometimes longer for large or complex homes. But that range hides a lot, and understanding the phases behind it is what lets you plan realistically rather than be surprised. I am Robbie English, Broker, REALTOR at Uncommon Realty, and I have guided buyers through this process in Dripping Springs.

How Long Does It Take to Build a Luxury Home in Dripping Springs

Why the Hill Country setting affects the clock

Dripping Springs is not a subdivision where a builder drops the same floor plan on a flat, utility-ready lot. It is Hill Country: acreage, karst limestone geology, and, on most properties, private wells and septic systems rather than city utilities. That setting is a big part of the appeal, but it also adds steps a suburban build never faces. The land itself, the rock beneath it, and the way a property gets water and handles wastewater all feed directly into the timeline. If you are still in the land stage, I cover that groundwork in depth in my guides on what to know before buying land in Dripping Springs and what luxury buyers should know about Hill Country land, so here I will focus on the build timeline itself.

Phase one: land and due diligence

Before the build clock even starts, you need the right piece of land and a clear understanding of what it will support. Due diligence, confirming access, checking for a viable well and septic location, understanding topography and any Edwards Aquifer recharge-zone requirements, and reviewing deed restrictions, can take anywhere from a few weeks to a few months depending on how quickly the right lot appears and how complicated it is. This phase does not always count in a builder's "construction time," but it is real time in your calendar, and rushing it is where a lot of timeline pain later begins.

Phase two: builder selection and pre-construction

Choosing the right custom builder and getting under contract usually takes several weeks, and it is worth every day. The quality builders in Dripping Springs book out in advance, so their availability can itself add lead time to your start. This is also where you settle the contract structure, most often a fixed-price contract or a cost-plus arrangement, each with different risk and budget implications. Expect roughly one to two months for the pre-construction stage of selecting your builder, aligning on budget, and getting the paperwork in place before design work fully ramps.

Do not shortchange builder vetting to save a few weeks here. Interview more than one, ask to see completed Hill Country homes and to speak with past clients, and confirm the builder is comfortable with acreage sites, wells, septic, and rock. A builder who regularly works in Dripping Springs will already understand the county's requirements and the local trades, which quietly removes friction from every phase that follows. The right builder relationship is the single biggest lever on whether your build runs near the short end of the range or the long end, so the time invested in choosing well pays back many times over across the following year and a half.

Phase three: design and architecture

This is the phase buyers most often underestimate. A genuinely custom luxury home needs architectural plans drawn to your specifications, engineered for the site, and refined through revisions, and that process commonly runs two to six months. The more custom and complex the home, the longer it takes, and design changes made late in this phase ripple into everything downstream. Time spent getting the plans right here is time saved during construction, because changes are far cheaper on paper than in framed walls.

Your Dream Home Starts Here

Phase four: permitting and approvals

Permitting in the Dripping Springs area typically adds about four to ten weeks, and where your property sits determines the process. A home inside the City of Dripping Springs goes through the city's permitting; a home in unincorporated Hays County goes through the county instead, with different requirements and timelines. On acreage, you are usually also permitting a septic system, an On-Site Sewage Facility, and if you are in the Edwards Aquifer recharge zone, additional environmental review can extend this stage. Well drilling scheduling can factor in here too. This is a phase where local knowledge of which jurisdiction you are in, and what it expects, keeps things moving.

Phase five: construction

Actual construction of a custom luxury home in Dripping Springs generally runs about 10 to 16 months, and larger or more intricate homes can run longer. The sequence moves from site preparation and foundation through framing, mechanical systems, exterior and roofing, interior finishes, and final inspections. Hill Country sites add their own wrinkles: rock excavation for foundations and pools takes longer and costs more than digging in softer soil, and long private driveways or utility runs add work. High-end finishes and custom features, imported materials, specialty millwork, and detailed stonework, also carry lead times that can stretch the back half of the build.

It helps to picture the construction sequence, because each stage depends on the one before it. Site work and the foundation come first, and on rocky Hill Country lots this is often where surprises appear. Framing follows and gives you the first real sense of the home's scale. Then come the systems, plumbing, electrical, and HVAC roughed in before walls close, followed by insulation, drywall, and the exterior envelope and roof. The final months are finish work: cabinetry, flooring, stone and tile, fixtures, paint, and landscaping, ending with municipal or county inspections and the certificate of occupancy. Any single specialty trade running behind, or one material back-ordered, can pause the stages that depend on it, which is why the back half of a luxury build is where schedules most often slip.

Financing and how it shapes the schedule

How you pay for the build also touches the timeline. Many custom homes are financed with a construction loan, often a construction-to-permanent loan that converts to a standard mortgage once the home is complete. These loans release funds in stages called draws, tied to construction milestones and verified by inspections, so your lender effectively becomes part of the schedule. Lining up your financing early, and choosing a lender experienced with custom construction in the Hill Country, keeps the draw process from becoming a bottleneck. It also means budgeting for the reality that you may be carrying land, loan interest, and possibly a current housing payment at the same time during the build, which is a planning consideration as much as a scheduling one.

What moves the timeline most

A few factors drive the difference between a 14-month build and a 24-month-plus build. Site complexity is near the top: steep slopes, heavy rock, and difficult access all add time. Design changes and change orders are next, because every mid-build revision resets part of the schedule. Material and labor availability, permitting jurisdiction, weather, and the installation of well, septic, and utilities all play a role too. The single biggest thing within your control is decisiveness in the design phase; buyers who lock their plans early and resist major changes almost always finish faster. For a fuller look at the pitfalls that stretch timelines and budgets, my guide to the biggest mistakes buyers make when building in Dripping Springs is worth reading alongside this one.

A realistic total, and how to protect it

Putting the phases together, a realistic expectation for a custom luxury home in Dripping Springs is roughly 14 to 24 months from starting the process to move-in, with the land search sitting on top of that if you do not already own your lot. You protect that timeline by buying the right land with clear eyes, choosing a proven builder early, finalizing your design before breaking ground, and understanding your permitting jurisdiction from the start. None of this is about rushing; it is about sequencing the work so each phase feeds cleanly into the next instead of stalling it. Setting that expectation honestly at the start also protects your peace of mind, because a build that takes the time it was always going to take feels very different from one you expected to finish months sooner.

How I help

My role as your representative is to protect your interests across this entire process, not only at the closing table for the land. I help you evaluate lots for buildability before you commit, connect you with reputable local builders, and keep the transaction and the diligence organized so the timeline holds together. Building custom is one of the most rewarding ways to own in the Hill Country, and it goes far more smoothly with someone in your corner who knows the area. My team and I do this work throughout Dripping Springs, and you can reach the Uncommon Realty team whenever you want to talk it through.

If you are starting to think about a custom build, the best first move is to get clear on land and budget. Download my real estate app to follow Dripping Springs land and homes in real time and reach me directly with questions. When you are ready to map out your build from land to move-in, I am here to help you do it with a realistic timeline and clear expectations.

Written for buyers and sellers in the Greater Austin, Texas area by Robbie English, REALTOR, Broker at Uncommon Realty.

Dripping Springs custom luxury home build timeline phases

Share on Social Media

SHARE YOUR FEEDBACK

Name
Phone*
Message

By checking this box, I agree to the Terms of Service and Privacy Policy of this website
